Project Story · Water & Sanitation

From a Conversation to Clean Water

How a January site visit between Benjamin Runga Foundation and Big Five Tanzania became a working well serving our students and the community around our Arusha computer centre, told here with the same financial detail we share with our partners.

~20mWell Depth
$1,264Granted by Big Five Tanzania
1,000+Learners Since 2022
Aug 2026Well Completed

Water You Can't Count On

Arusha's city water supply reaches Benjamin Runga Foundation's centre, but not reliably. Interruptions are frequent enough to affect everyone: students in our free ICT training and the community living around the centre, who share the same unpredictable supply.

For a training centre that has hosted more than 1,000 young people since 2022, running computer labs and keeping toilets working, reliable water is essential to good WASH conditions. We needed a solution.

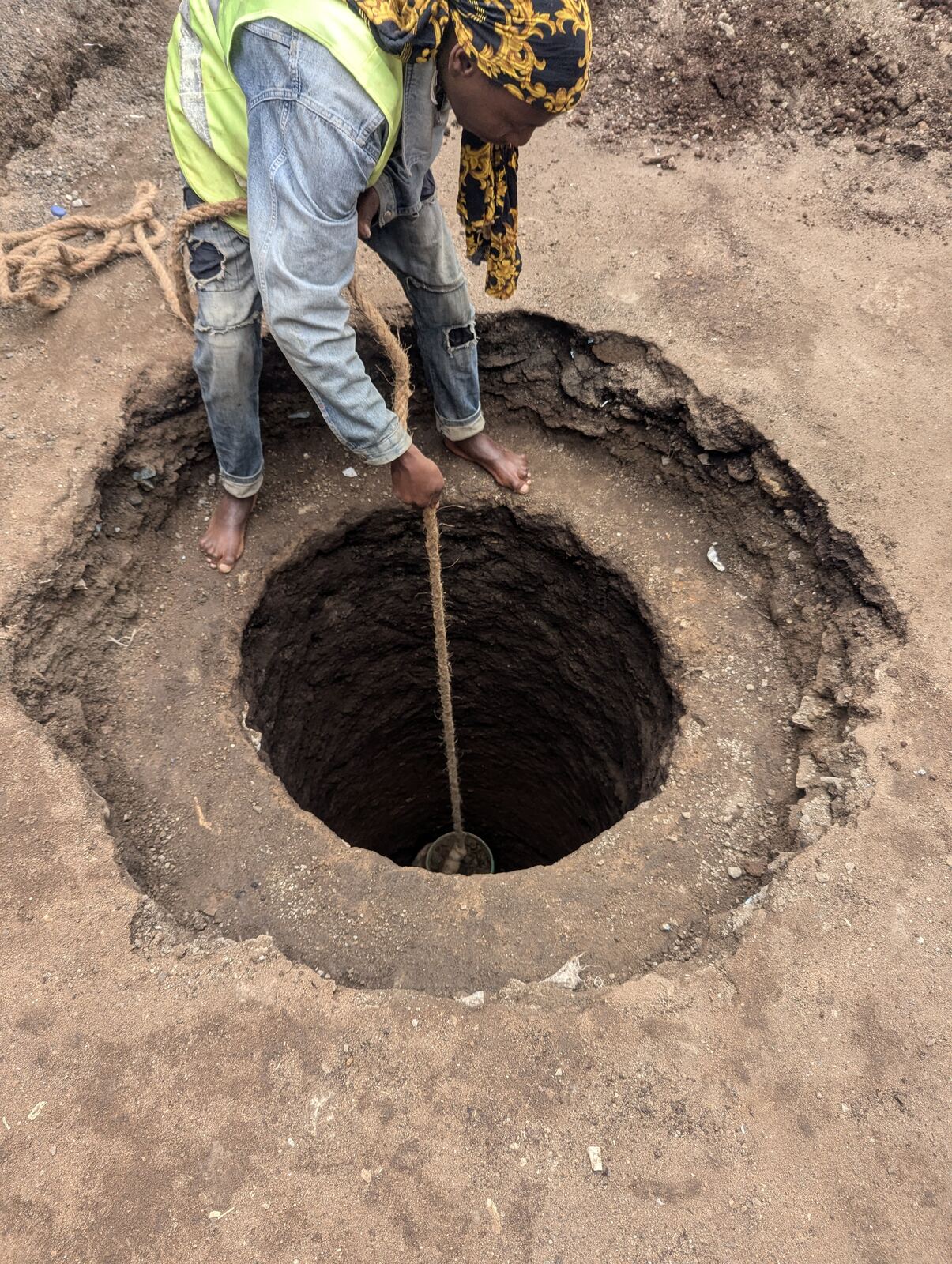

BRF team measuring the depth of the hand-dug well during construction
Well digging in progress, July 2026.

A Call, Then a Visit

Most partner stories skip straight to "funded." Ours didn't start there. It started with an honest conversation about what we actually needed.

On January 5, 2026, we spoke with Laura from Big Five Tanzania for the first time. The goal was simple: help each organisation understand the other well enough to see where we might work together. We shared several needs openly: support for a key volunteer's stipend, water storage for sustainability, a stronger solar power system, and replacement computers for our oldest, most failure-prone machines, along with how we'd track and report the impact of each.

Laura proposed visiting our computer lab in Sinoni, Arusha, in person, and on January 27, 2026, she and the Big Five Tanzania team did exactly that. We walked them through our story (founded in memory of Benjamin Runga to fulfil his dream of tech education) and our numbers: a student body that is 68% female across all our intakes to date, and more than 1,000 learners reached since 2022. They met our students in the classroom and toured the building, including the areas most affected by our water shortage.

The visit with the Big Five Tanzania team was productive. We didn't only show them what was working; we were candid about what wasn't: ageing, unreliable computers; a solar system that only powers 5-7 machines for about three hours; the need for a second lab; and yes, water and sanitation limitations that affect day-to-day operations. That honesty turned out to matter.

"They did not expect this level of organisation and impact. They appreciated our transparency on challenges and our community-driven approach." Ramadhan, BRF's Operations Manager
Ramadhan speaking with Laura and the Big Five Tanzania team during their site visit
January 27, 2026
Walking the CompoundRamadhan and the BRF team hosting Laura's delegation.
Group photo of the BRF team and Big Five Tanzania delegation after the site visit
January 27, 2026
End of the VisitBRF and Big Five Tanzania, together at the centre.

Big Five Tanzania works across education, entrepreneurship, healthcare, food security, and clean water. Comparing notes, two areas stood out as strong fits: clean water access and entrepreneurship support for BRF graduates, a second strand of the partnership now being scoped. When the conversation turned to water specifically, we weighed a simple rainwater storage tank against digging a well, and recommended the well: the more sustainable, cleaner option that could also serve the surrounding community, not just our own centre.

The visit ended with an agreement in principle to partner on both fronts. Our task: put together a real proposal.

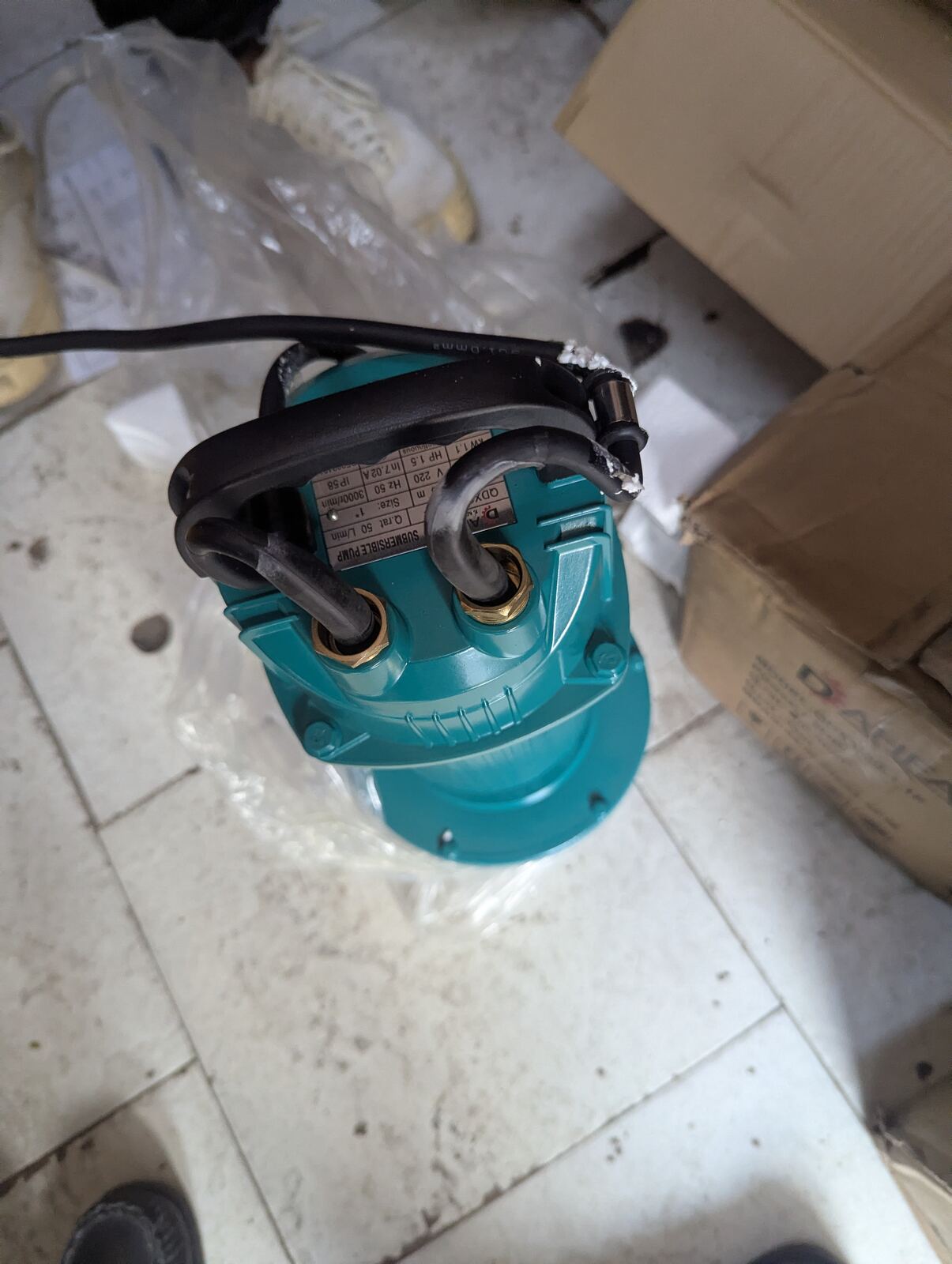

The submersible water pump purchased for the well project
The submersible pump we ultimately selected. More on why below.

The Cost Estimate

Before asking for a shilling, we ran a proper feasibility survey.

That survey told us we could reach a reliable water-bearing formation at a depth of about 50 metres. Machine drilling was an option, typically around TSH 75,000 ($28.72) per metre, but on May 18, 2026, we sent Laura and the Big Five Tanzania team a formal cost estimate recommending hand-digging instead: equally effective, and it kept the project well within the budget Big Five had in mind.

Why hand-dug, not drilled?

At about 50 metres, drilling alone would have run TSH 3,000,000-3,750,000 (about $1,148-$1,437), before pump, electrical, or plumbing costs. A hand-dug well at the same depth was estimated around TSH 2,500,000 ($957), leaving room in the budget for a proper pump, wiring, and plumbing without asking Big Five Tanzania for more than they'd offered.

The proposal was approved, and we were ready to dig.

The Work, Dated

These aren't stock photos. Every image below is from the actual build, by a local hand-digging crew and tradespeople we hired in Arusha: this is what the grant paid for, week by week.

Measuring the depth of the well during hand-digging
July 10, 2026
Digging & Depth ChecksChecking progress as the hand-dug well goes deeper.
The DAHFA submersible pump purchased for the well
July 14, 2026
Sourcing the PumpA DAHFA 1.5HP submersible pump, chosen for durability.

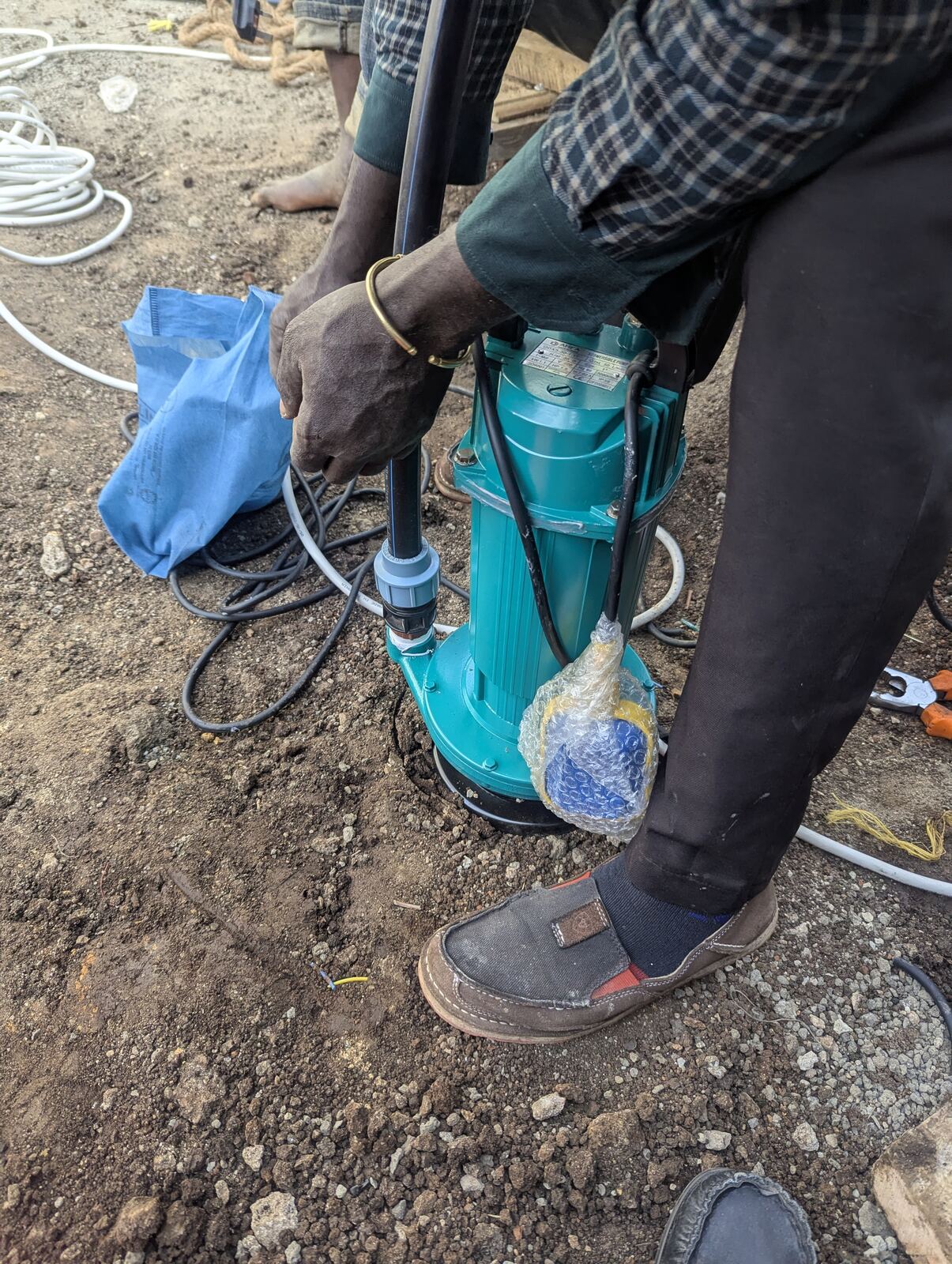

Installing and wiring the submersible pump
July 14, 2026
Pump InstallationWiring and lowering the pump to roughly 15 metres.

Brick-lined well opening with scaffolding for the masonry housing
July 24, 2026
Well Housing BeginsBrick lining and scaffolding for the masonry well housing.

Testing water flow from the newly dug well into storage buckets
July 24, 2026
First Water TestDrawing and testing water flow before final connections.

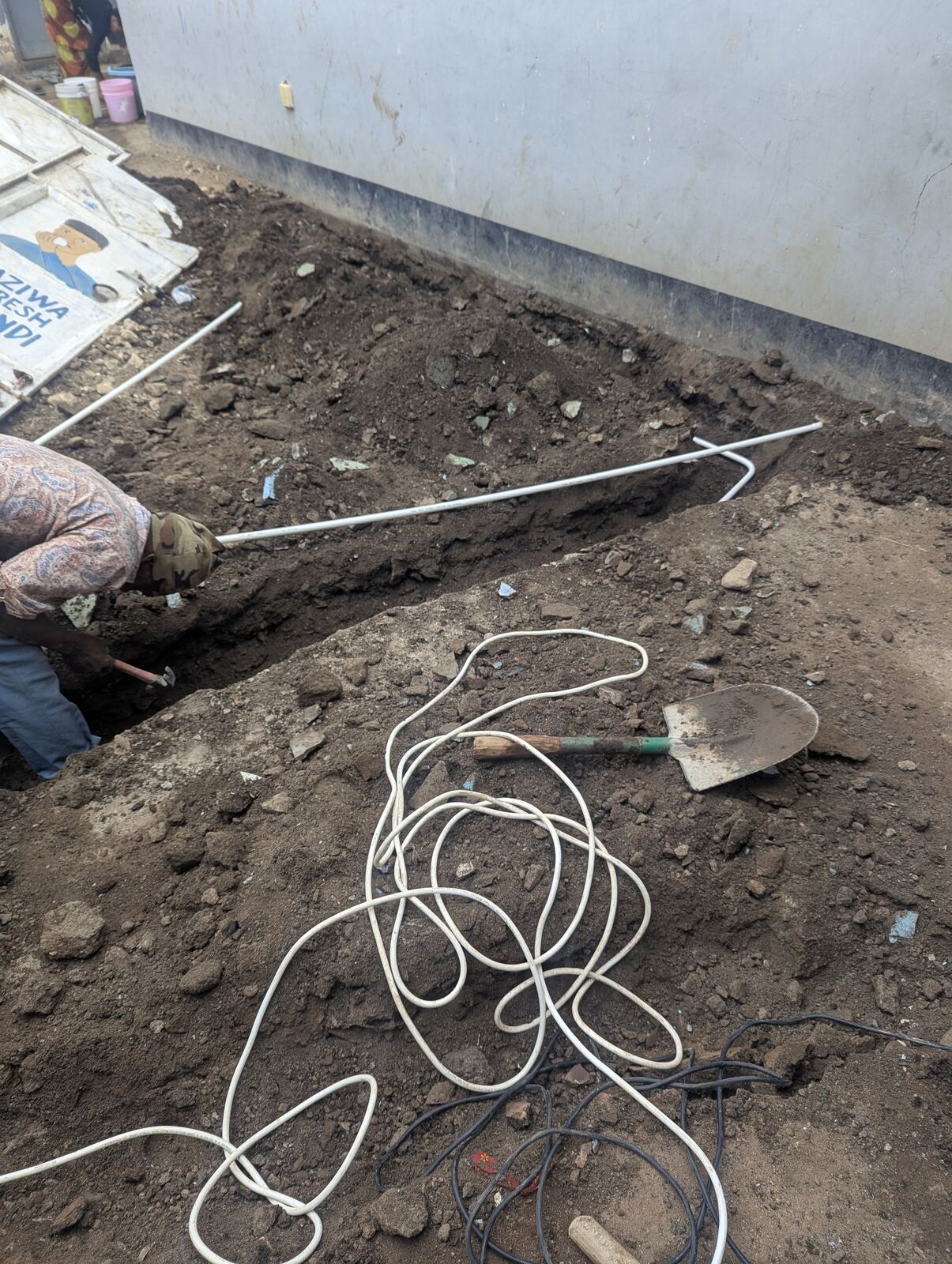

Digging a protective trench for the underground electrical cable
July 27, 2026
Electrical TrenchingRouting a protected underground cable run to the pump.

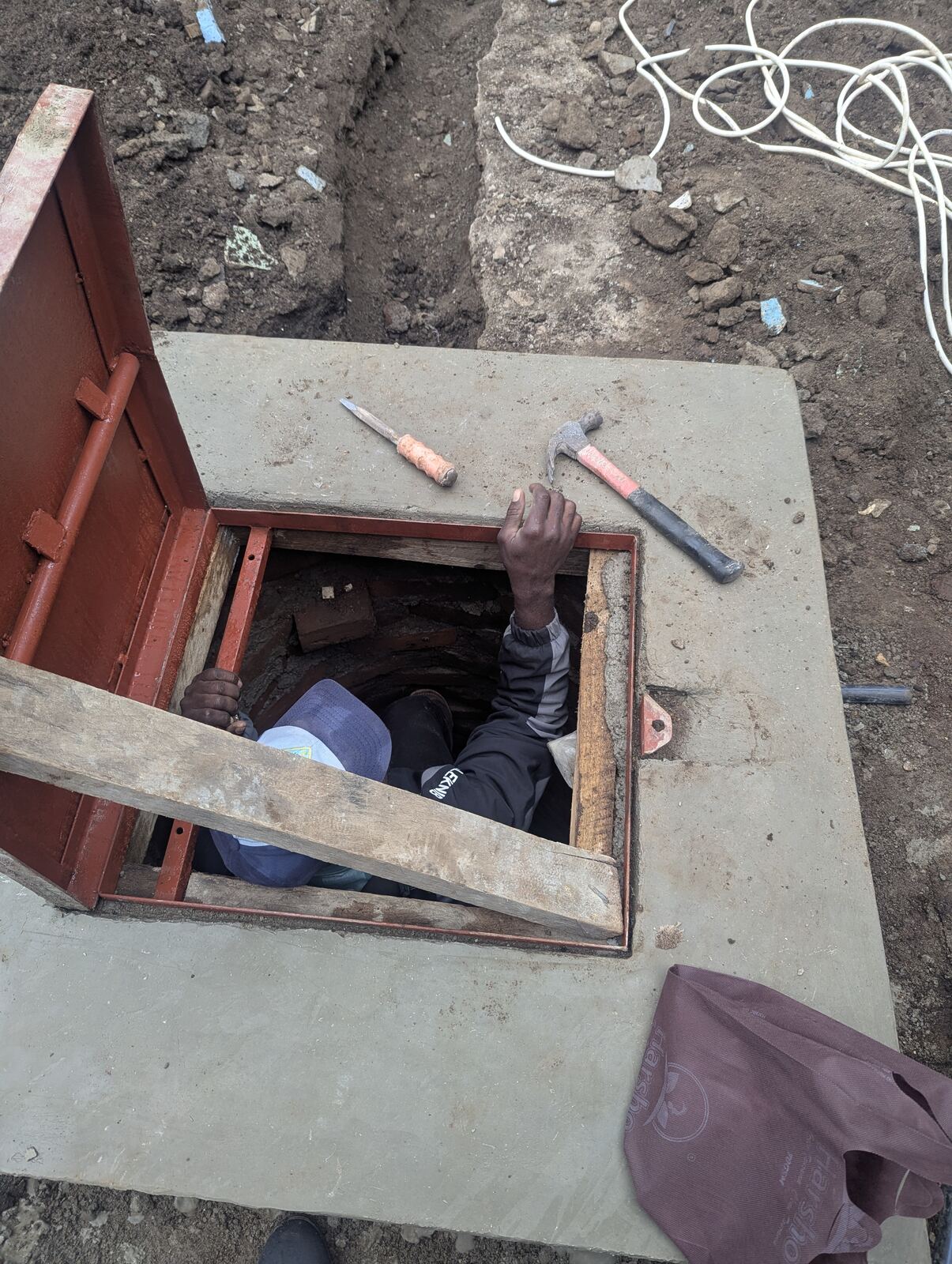

The well housing opened up so the team could finish wiring the pump from inside
July 27, 2026
Opening the HousingThe steel cover opened up to finish wiring the pump from inside.

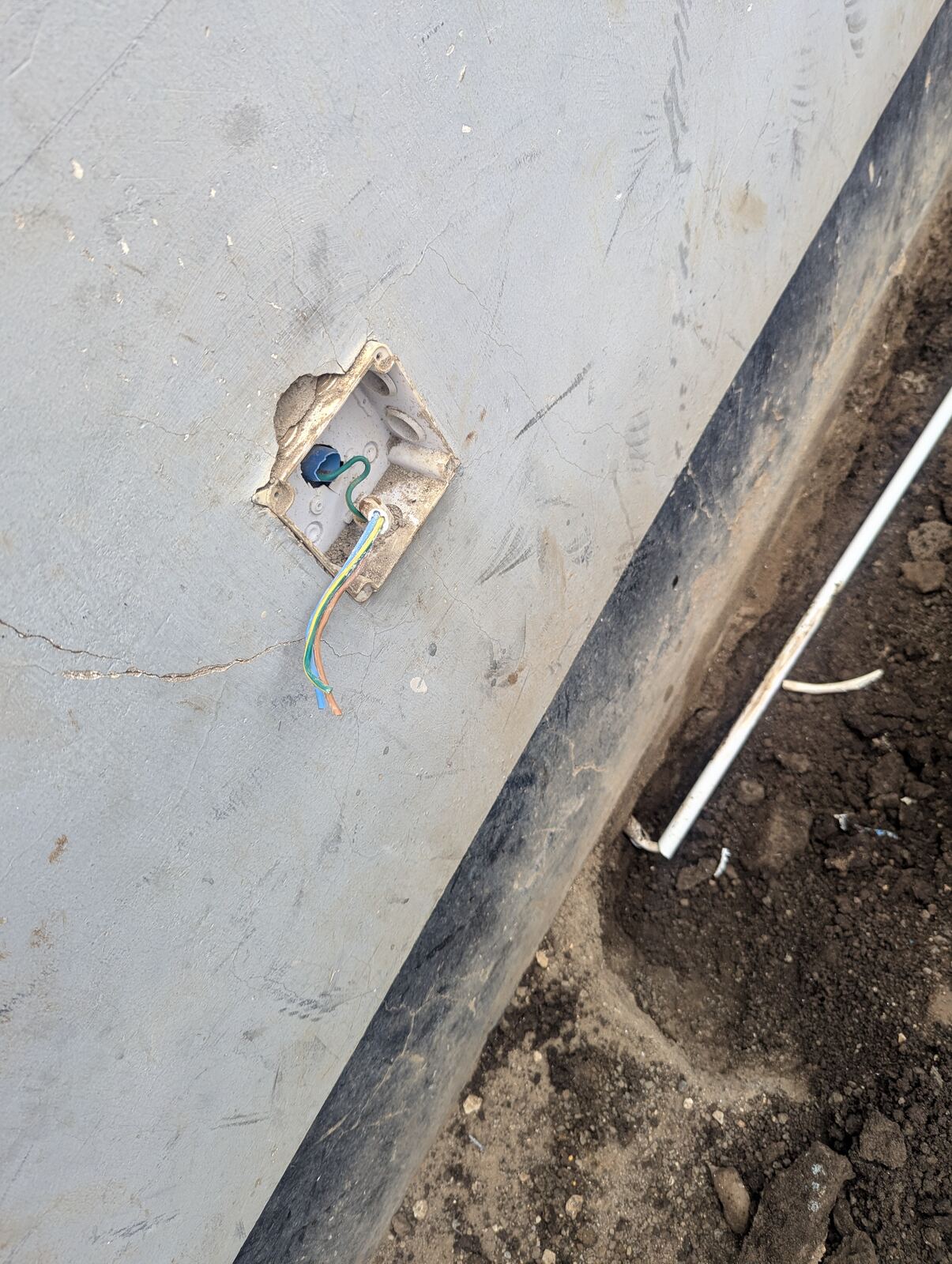

Wiring the exterior pump control switch into the housing wall
July 27, 2026
Wiring the SwitchSetting the pump control point into the housing wall.

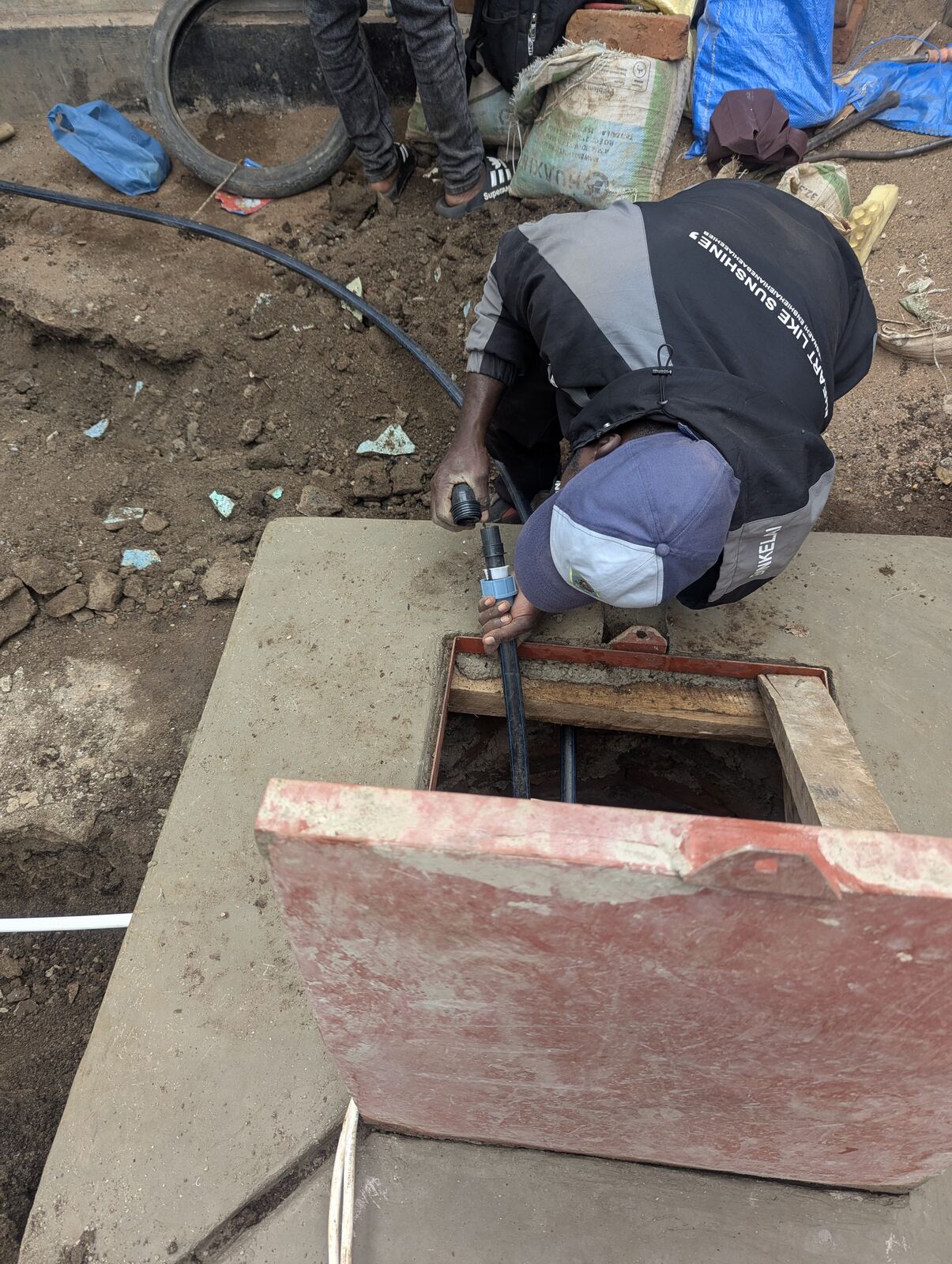

The steel well cover closed and sealed after wiring was finished
July 27, 2026
Sealed & SecuredThe steel cover closed and locked down once the wiring was finished.
Water flowing from the completed well into buckets, the first successful test
July 27, 2026
Water FlowingSame day, water reaches the tap for the first time.

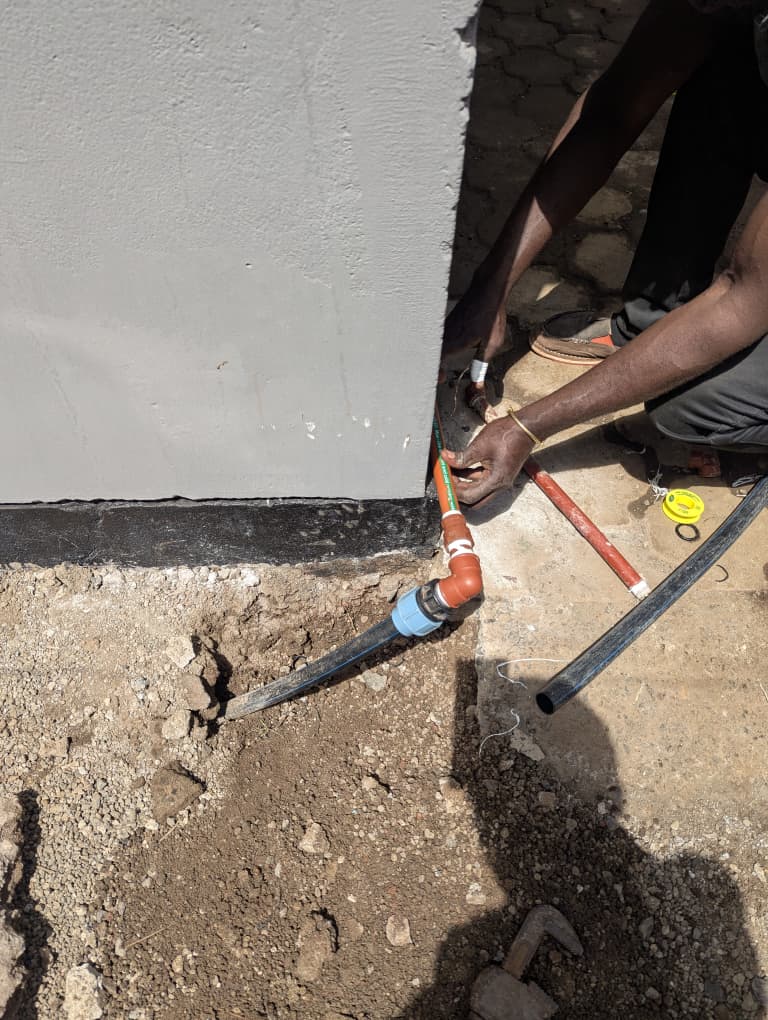

Pipe run carrying water from the well pump to the storage tank
August 28, 2026
Connected to the TankThe pump feeding the first-stage storage tank.

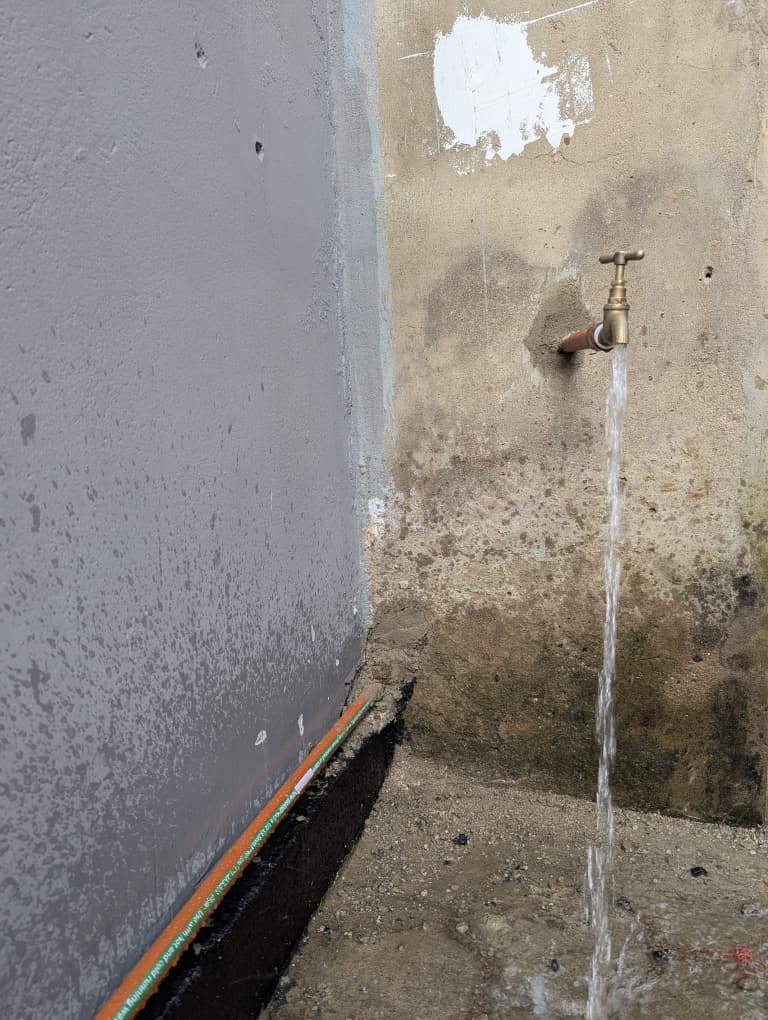

Water running freely from the tap at the finished well
August 28, 2026
In ServiceThe tap running for students and the surrounding community.

Why we stopped at 20 metres, not 50

Our survey indicated a water-bearing formation down to about 50 metres, but digging that deep wasn't necessary. We reached a strong, reliable source at roughly 20 metres, with yield sufficient for our needs. Groundwater at greater depths in this area can also carry higher mineral content, so stopping at a productive level was the right call for both practicality and water quality, not a shortfall against the original estimate.

Full Financial Transparency

This is the same level of detail we shared directly with Big Five Tanzania in our August 2026 completion report: nothing rounded off, nothing left out.

US dollar figures are converted from Tanzanian shillings at about TSH 2,611 to the dollar (the rate applied in the completion report, August 2026).

Total Received $1,263.88 TSH 3,300,000
Total Spent $1,183.32 TSH 3,130,200
Balance Remaining $64.19 TSH 169,800, held toward a larger tank

Below is the full itemised breakdown by category. Each includes the honest story behind the number: where we saved, where we spent more than planned, and why.

1. Well Construction $765.99
ItemTSHUSD
Hand-dug well, approx. 20m depth (negotiated rate)2,000,000$765.99
The original quote from the digging team was a flat TSH 2,500,000 ($957.68) regardless of final depth. After negotiation, we brought that down to TSH 2,000,000 ($765.99), a saving of TSH 500,000 ($189.02) that we redirected into finishing the well housing properly (see Masonry, below).
2. Water Pump $111.07
ItemTSHUSD
DAHFA Submersible Water Pump (1.5 HP)290,000$111.07
Our original estimate budgeted TSH 250,000 ($94.51) for a 2HP pump. When we went to buy one, a reliable, long-lasting 2HP model actually cost closer to TSH 400,000 ($153.20), while 2HP options at our original price point were low quality. Rather than install a more powerful but short-lived pump, we chose a high-quality 1.5HP DAHFA unit for TSH 290,000, TSH 40,000 ($15.32) over budget, but far better long-term value.
3. Electrical Works $78.33
ItemTSHUSD
Electrical cable, 2.5mm 3-core flexible, 30m @ TSH 4,000/m120,000$45.36
Wall switch socket (13 Amp) for pump control7,200$2.76
Electrician labour (negotiated from TSH 80,000)50,000$18.90
2-inch protective pipe for underground cable30,000$11.34
Electrical Total207,200$78.33
Electrician labour was budgeted at TSH 80,000 but negotiated down to TSH 50,000, saving TSH 30,000. We used that saving to buy a 2-inch protective pipe so the underground cable isn't left exposed: a safety and durability upgrade, not a corner cut.
4. Plumbing & Water Distribution $64.70
ItemTSHUSD
HDPE pipe, 3/4", 35m @ TSH 1,500/m52,500$19.85
Water tap16,500$6.32
Clamps, fittings & plumbing labour100,000$38.30
Subtotal169,000$64.70
The original plumbing budget assumed 50 metres of pipe and two taps (TSH 258,000). During installation we right-sized this to 35 metres and one tap, and negotiated lower rates on fittings and labour, a saving of roughly TSH 89,000 ($33.65) that flowed into the project's remaining balance.
5. Masonry & Well Housing $177.71
ItemTSHUSD
Building sand50,000$19.15
Burnt clay bricks (250 @ TSH 400)100,000$38.30
Cement (6 bags @ TSH 19,000)114,000$43.66
Crushed stone (gravel)50,000$19.15
Steel well cover (fabrication & welding)70,000$26.81
Masonry labour80,000$30.64
Subtotal464,000$177.71
This wasn't a separate line in the original budget. It was funded entirely from the TSH 500,000 saved by negotiating the digging cost down. Of that saving, TSH 464,000 ($177.71) finished the masonry housing and steel cover; the remaining TSH 36,000 ($13.61) went back into the general project balance.
Project Funds: Final PositionTSHUSD
Total received from Big Five Tanzania3,300,000$1,263.88
Total spent3,130,200$1,183.32
Balance remaining (held toward a larger tank)169,800$64.19

Built to Run Without More Grant Money

The well is complete, connected to a first-stage storage tank, and delivering water to the centre and the community around it.

More than 1,000 young people have gone through BRF's free ICT training since 2022. This well removes water shortages as a disruption to that training. It also gives the community around the centre, who have lived with the same city-water shortages, a reliable and affordable water supply.

"Water shortage: the toilet facilities lacked water, requiring fetching from a distant source." Week after week through 2025: "No tap water. The cleaner fetches water from far away." BRF weekly operations reports, 2025

We didn't want the well to become an ongoing cost for BRF once the grant was spent, so it runs on a simple community contribution model designed to cover its own electricity and maintenance.

How the running costs are covered

The well's only recurring costs are pump electricity and routine maintenance. The community around the centre contributes toward them, at rates agreed with the community and documented in our completion report to Big Five Tanzania: a small fixed amount for regular ongoing use, and a set price per bucket for water drawn occasionally.

Contributions go to the well's electricity and upkeep first. Anything above that cost goes back into BRF's free ICT programme; if a month falls short, BRF covers the difference so the water keeps running. We will publish the first six months of actual collections and running costs once we have them.

We plan to have the water tested for drinking safety as a next step.

Water running from the tap at the finished, working well
Water in service at the finished well, 28 August 2026.
1,000+Learners Since 2022
~20mWell Depth Reached
Aug 2026Water in Service to the Centre & Community
$0Ongoing Cost to Donors

The first-stage storage tank installed and connected to the well
The first-stage storage tank, connected and in use, 28 August 2026.

The Next 5,000 Litres

The well is done and running on community contributions, not grant money. The next step is a larger tank on a raised tower.

A 5,000-litre storage tank lets the system hold a full day's supply. At that size it also needs its own raised tower for the pressure to reach the taps, so the next step is the tank plus a tower to carry it. The tank is about $334; building the tower and supplies is roughly $850 to $1,000, so the whole job comes to somewhere near $1,200 to $1,335. The $64.19 left in the project balance and the monthly community contributions cover the first part; a gift of any size closes the rest and gets it installed sooner. Day-to-day management stays with BRF's operations team: monitoring pump usage, checking the tank, and handling routine maintenance. We're continuing to update Big Five Tanzania directly as the tank expansion moves forward.

For Future Partners

How We Run a Project, Start to Finish

From a first phone call to a finished well that runs on community contributions, not repeat funding: honest conversations about what we need, transparent budgets, dated progress photos, and full reporting on where every shilling went. The next step is the 5,000-litre tank and the tower to carry it. The project balance and community contributions cover the first part of the cost; a gift moves it forward faster.

"Thank you again to you and your team for taking the time to visit us... we hope the visit was as meaningful for your team as it was for ours."
Ramadhan, Operations Manager, Benjamin Runga Foundation, in a note to Laura and the Big Five Tanzania team

Published August 2026 · Benjamin Runga Foundation · With thanks to Big Five Tanzania and Laura.
